How Tank Installation Works in Minnesota
Tank installation demand in Minnesota centers on the Twin Cities metro. Fueling sites from the 1970s and 1980s are reaching end of life, driving steady replacement work from gas stations, fleet operations, and convenience stores across Minneapolis and St. Paul. Rochester supports consistent project flow from medical campus fleet operations and regional fuel distribution, while Duluth and the Iron Range see fewer but often urgent projects where aging infrastructure meets harsh winters. Agricultural cooperatives around Mankato, St. Cloud, and Willmar form a separate market segment, replacing single-wall steel bulk fuel tanks installed decades ago to meet current federal standards. Minnesota's frost line reaches four to five feet deep, which shapes every aspect of tank installation from excavation timing to backfill specifications.

The state pollution control agency requires company-level certification for any contractor performing UST installation, removal, or repair in Minnesota. All new tanks must meet double-wall construction standards with interstitial monitoring, continuous leak detection, and secondary containment on all piping runs. Owners must notify the agency at least ten days before installing a tank system and file a notice within thirty days of bringing it into use, under Minn. R. 7150.0090. Freeze-thaw cycling across the state means tank bedding and backfill standards are stricter than in warmer climates, with contractors required to demonstrate cold-weather protocol familiarity for certification renewal. Local fire marshals also review site plans, adding a second permitting layer that varies by jurisdiction.
A single-tank installation in Minnesota typically costs $50,000 to $140,000, with the final price depending on tank capacity, site access, and soil conditions. Multi-tank gas station buildouts with dispensers, canopy, and monitoring systems run $250,000 to $500,000 or more, and monitoring equipment adds $5,000 to $15,000 per tank. Winter installations between November and March carry a premium of 10 to 20 percent because frozen ground requires mechanical breaking or thermal thawing before excavation can begin. Minnesota's Petrofund operates on a 90/10 copay structure and may reimburse eligible cleanup costs if contamination from a prior tank is discovered during a new installation. The facility owner pays upfront and waits for board approval that can take 12 months or longer. Sites with heavy clay soils common across southern and central Minnesota also increase excavation time and overall project cost.

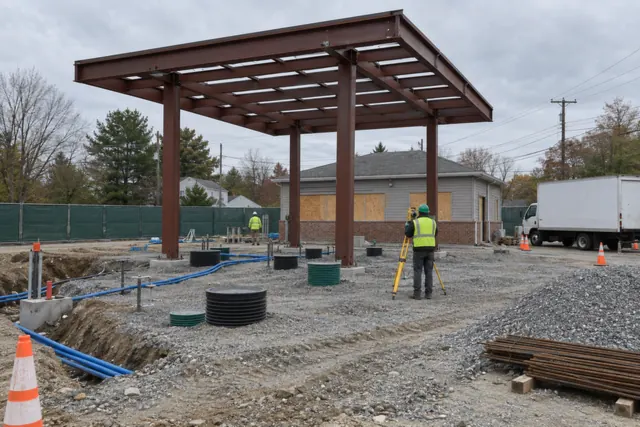

Local fire marshal permitting, plus the state's ten-day advance notice, takes four to ten weeks depending on the jurisdiction and project scope. Site work follows a standard progression: excavation, bedding, tank placement, piping connections, backfill, dispenser installation, and full system testing, with a single-tank project typically requiring two to four weeks of on-site work once permits clear. Before signing a contract, confirm the company holds current hazardous materials training and carries pollution legal liability insurance, since standard commercial general liability policies have excluded pollution events since 1986. A fuel spill during installation without PLL coverage leaves the facility owner responsible for the full cleanup cost. Ask whether the contractor has completed winter installations in Minnesota specifically, and verify they handle both the state installation notices and post-installation testing as part of their scope.
